Imagine the new booster has just passed its final test. The installer points to the pressure gauge, everyone sees water reaching the building, and the team heads home. The next morning, the person on duty gets a call: an upper-floor tap is weak. The pump is running, but nobody is quite sure which tank feeds it, what pressure it was set to hold, or who can change the controls.
That is the real test of a Zamboanga booster handover. Can the people who will live with the system understand it without calling the installer every time something changes? They should leave with three things they can actually use: a clear picture of the water route, a plain-language record of the agreed controls, and a few readings that show what normal operation looked like. Add a named contact for problems and you have the beginning of a useful handover, not just a signed page.
Start with the water, not the control panel
Before anyone explains the buttons, walk the route together. Where does water enter the property? Where is it stored? Which pipe takes it to the booster, and where does it go afterward? You might think the answers would be obvious in a pump room. They often aren’t once labels fade, pipework is altered, or a different maintenance team takes over.
There is a local reason to be careful about the first part of that route. The Zamboanga City Water District’s booster-pump guidance says a booster must not draw directly from the meter or distribution line where pressure is low. Its installation guidance places a sump tank between the meter and the booster, with the downstream arrangement depending on the property. The owner and installer should check the actual approved connection, rather than assume the pump can simply be attached to the incoming line.

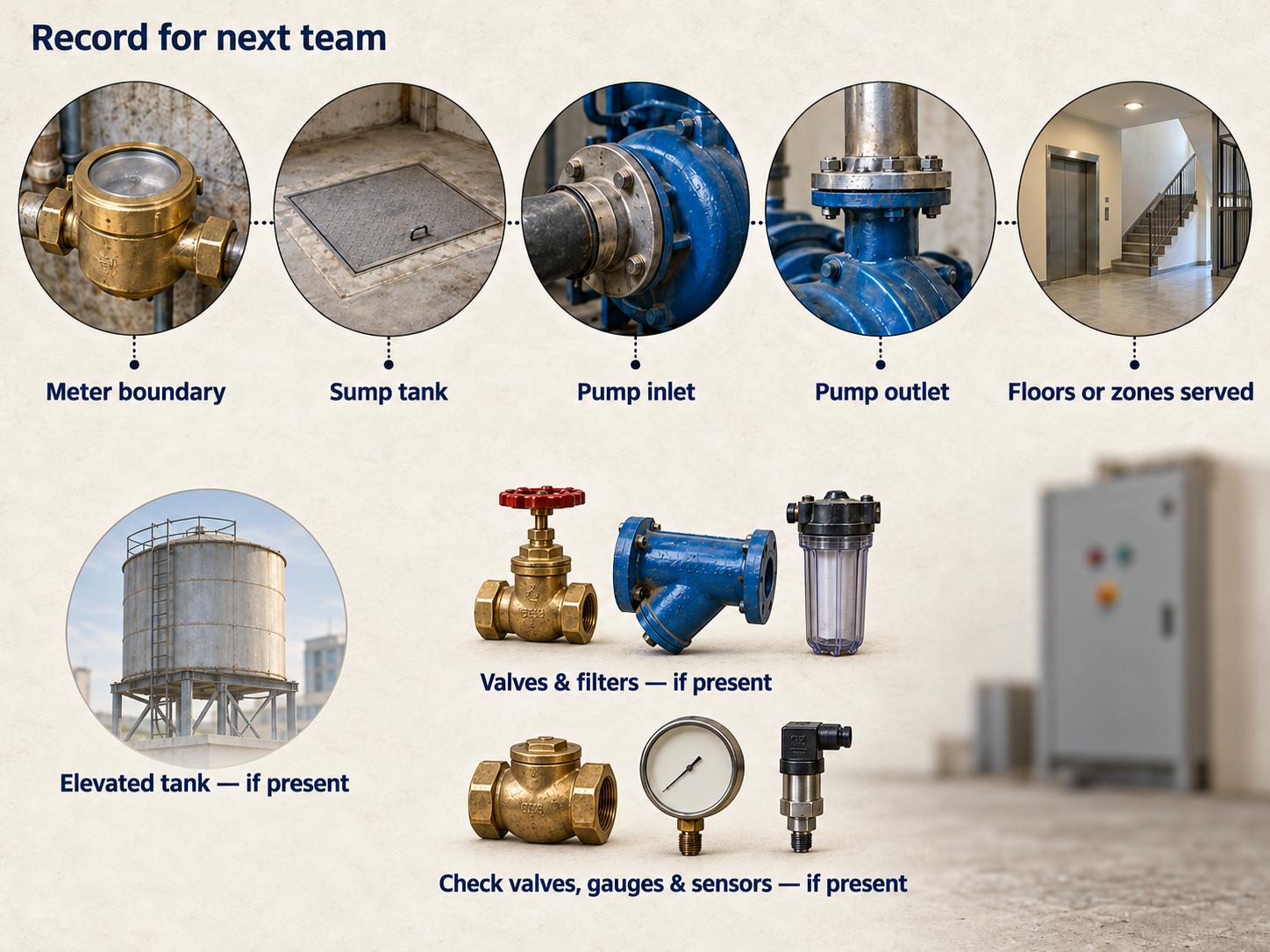

Ask the installer to mark the real route on one page: meter, sump tank, pump inlet and outlet, any overhead tank, and the floors or areas supplied. Add the important valves and the places where pressure is measured. A photo of the actual pipework is often more helpful than a beautifully drawn diagram that no longer matches the room. If a valve normally stays closed, label it. If a tank has a low-water stop, show the incoming team where its level is checked.
Here is a question worth asking on that walk: “If the top floor loses pressure tomorrow, how will we know whether the pump still has water to draw?” If nobody can answer without guessing, the map is not finished. A pump controller may adjust motor speed, but it cannot make up for an empty tank or a closed inlet valve.


Explain what the controls are meant to do
The next team does not need to memorize every parameter. They do need to know what the system was set up to do. Is it holding a pressure target as people open taps? Does a second pump join when demand rises? Is one pump kept in reserve, or do the pumps take turns? The answer depends on the actual equipment and design. Do not copy a description from another building and call it a handover.
Keep the approved settings with the equipment record: operating mode, pressure target, sensor location, pump sequence, low-water response, alarm meanings, and where the backed-up settings are stored. Put the date of the final approved change beside them. If settings are protected, say who may change them; keep passwords in the site’s secure process, not on a sheet left beside the panel.
Why bother writing down where the pressure sensor is? Suppose the display says pressure is normal but a gauge farther along the pipe reads lower. Those instruments may be looking at different points. Until someone knows where each reading comes from, changing the pressure target is guesswork. For a deeper equipment-side check, BEDFORD’s pressure-sensor guide explains what to compare before changing control settings. The handover’s simpler job is to make those comparison points easy to find.
There is also a difference between testing a drive and teaching the next person to operate the system. If the contractor still needs to prove motor rotation, protection, or pump sequencing, use a proper VFD commissioning checklist before acceptance. The handover should then translate the accepted setup into something the operator can recognize on an ordinary day. One cannot replace the other.
Keep a small record of a normal day

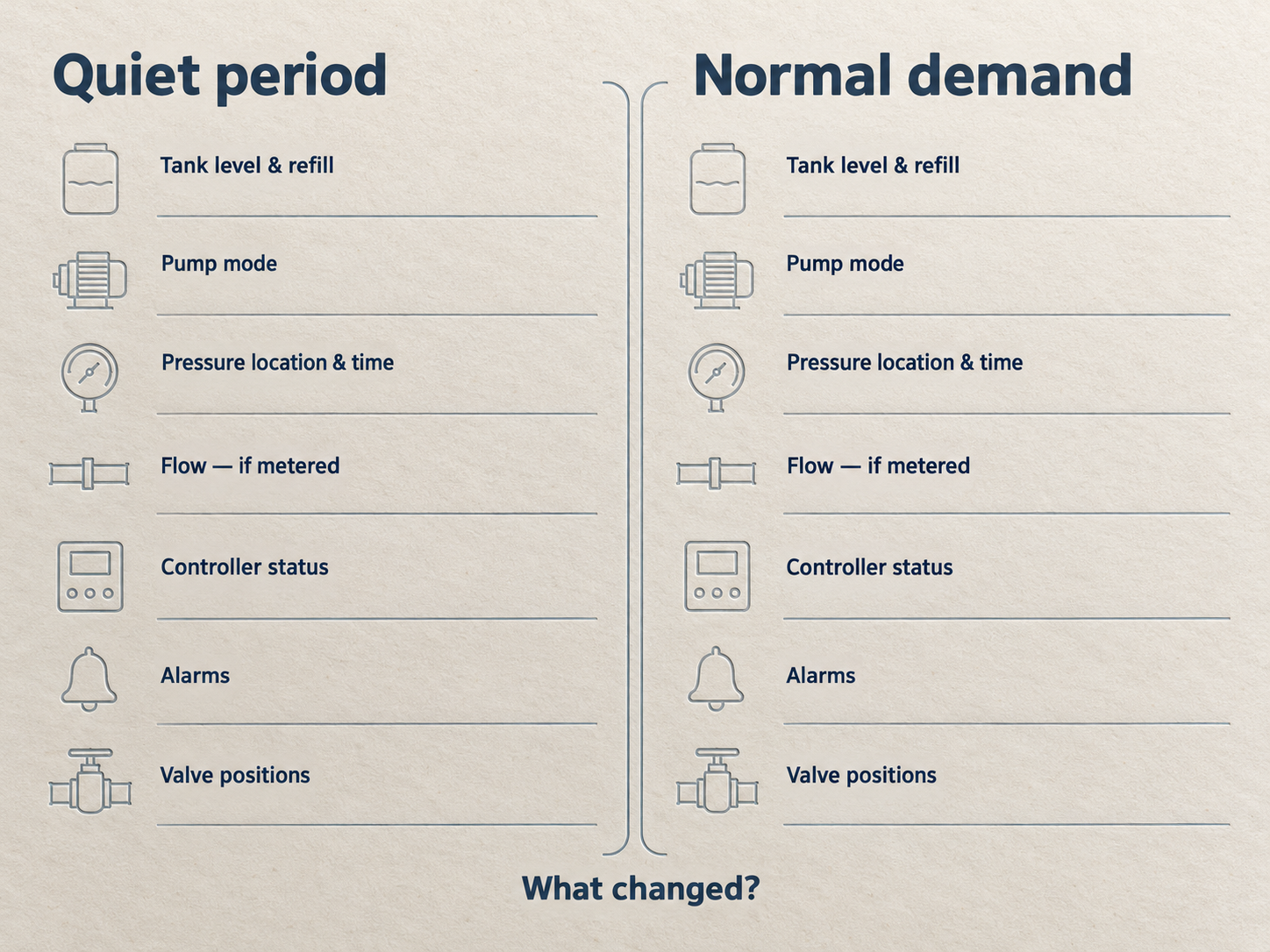

“The pressure was fine when we left” is hard to use a month later. A reading becomes useful when it has a time, a location, and a note about demand. Have the outgoing and incoming teams look at the system together while it is operating normally. If possible, take one set of readings during quieter use and another when the building is busier. If that second visit is not possible, say so rather than inventing a peak-demand result.
For each observation, write down the tank level, which pump is running, the pressure at the agreed gauge, the pressure shown by the controller, and the flow if the site has a meter. Note any alarms or unusual repeated starts. You do not need a perfect chart. You need enough context that a future technician can ask, “What changed since the handover?”
| What to leave on the sheet | What the next team can learn from it |
|---|---|
| Time, demand condition, and tank level | Whether the pump had a dependable water supply when the reading was taken. |
| Pressure with the gauge or sensor location | Whether a new reading is being compared at the same point. |
| Pump running, controller mode, and any alarm | Whether today’s operation matches the accepted setup. |
| Any known open item and its owner | What still needs attention instead of being mistaken for a new fault. |
You can see the value of that habit in water-utility operations, too. On its public operations page, the San Carlos City Water District describes keeping records of equipment status, water level, pressure, and pump flow. That is a different water district, not a rule for a Zamboanga apartment. The useful lesson is simple: tomorrow’s operator needs something real to compare with today’s complaint.


Agree on who does what when a complaint arrives
A handover is also about people. Who receives the first call from residents? Who can check the tank and visible gauges? Who is allowed to reset an alarm, change a pressure setting, or open an electrical cabinet? Who contacts the installer or supplier if the approved settings do not match what the panel shows? Write down names or roles and a current contact route. Check that the person taking over knows where the records are kept, not just that a folder exists somewhere.
Try one harmless conversation before signing. “The top floor has weak water. Where would you look first?” The new operator should be able to find the tank level and the agreed pressure reading, then describe what they would report to the qualified service team. Nobody needs to create a live fault or turn a valve for the exercise. If the tank is low, the first question is about supply and refill. If the tank is supplied but outlet pressure is weak, the pump and pipe route need closer attention. If the display and gauge disagree, the measurement path deserves a check. These are starting directions, not remote diagnoses.
One more small detail matters: leave unresolved items visible. If a label is missing, a busy-period reading has not been taken, or an alarm still needs an explanation, write it down with an owner and follow-up date. A signature should not make an unfinished job disappear. It should tell the next person exactly what has been accepted and what has not.
What would make the handover feel complete?
Ask the incoming team to tell the story back in their own words. They should be able to point to where the water comes from, explain which pump does what, find the normal readings, and know whom to call before changing anything they are not trained or authorized to change. If they can do that, the paperwork has done its job. If they cannot, spend another few minutes at the system while the installer is still there.
If the building later considers changing its pressure controls, BEDFORD’s water pump inverter range is one product category to review. Bring the actual pump, motor, tank, and control information to that conversation; those details decide whether a model fits. A good handover will make the discussion easier, because you will know what the current system was supposed to do before deciding what to change.
